By Sandra Schlagel, District 8 public affairs coordinator
Urban reconstructions don’t come along every year in District 8, so to have two in one year was a big undertaking filled with challenges for MnDOT, as well as the rural communities of Litchfield and Hutchinson. City officials, residents and business owners were concerned about losing business, navigating detours, getting access to their homes and businesses, as well as worrying about whether the historic buildings would be able to withstand heavy equipment and excavations during city utility upgrades.
Happily, efforts were made on the part of many to work collaboratively and meet the challenges inherent in urban reconstruction projects.
Early risk management contributes to success of Hwy 12 project in Litchfield

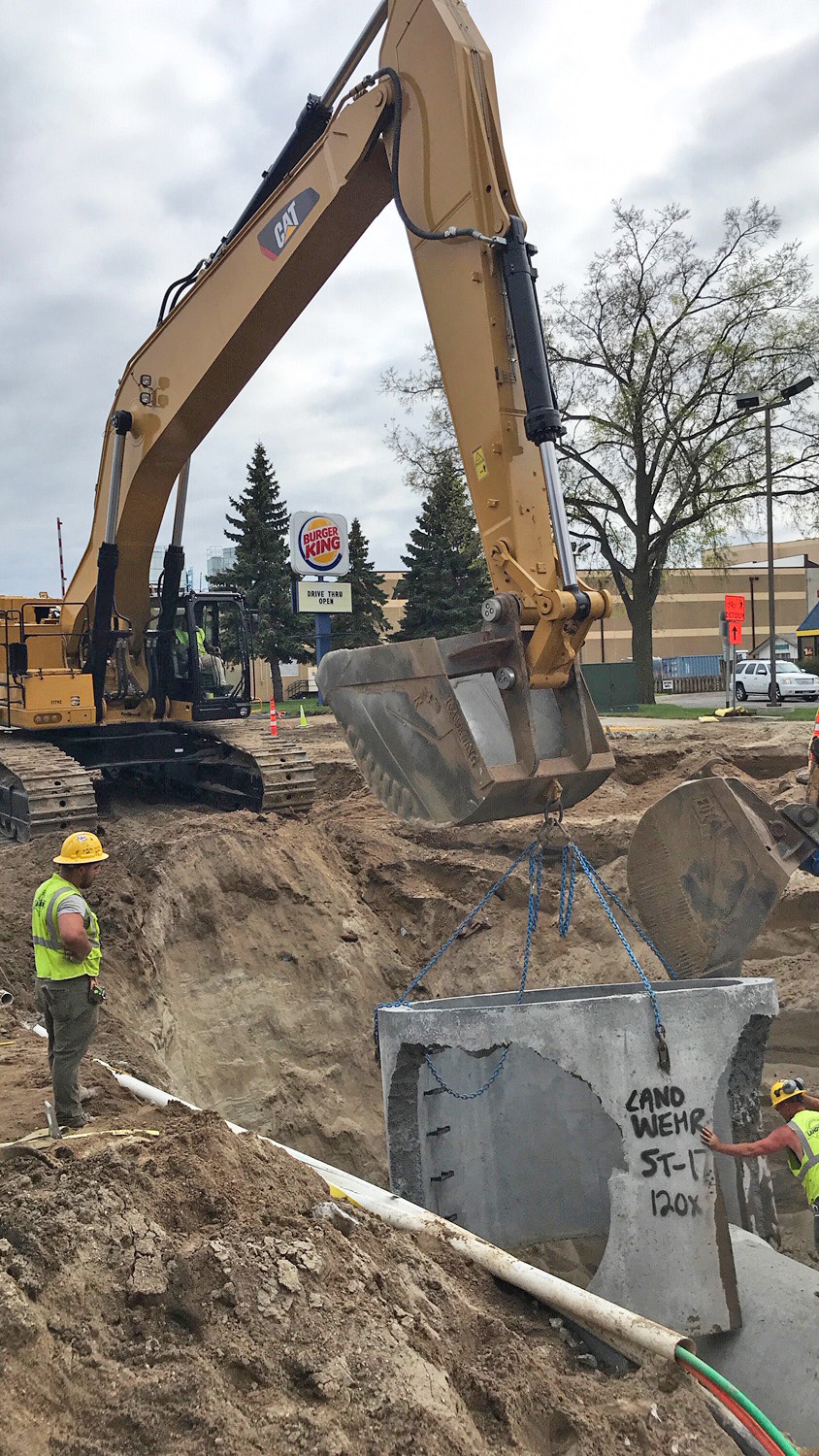

Crews replaced city utilities as part of the reconstruction project in Litchfield. Photo by Jon Gueningsman |
For Hwy 12 in Litchfield, MnDOT and the contractor worked hard to accelerate the project, recognizing the benefits to businesses and residents. Early risk management enabled the project to be completed seven weeks earlier than anticipated.
“This project will go down as one of my best in terms of a great prime contractor who scheduled and staffed the project very well,” said Al Setrum, MnDOT construction supervisor. “They were fantastic with local business owners and addressed every issue in a very timely way.”
The reconstruction of Hwy 12 in downtown Litchfield, along with utility updates by the city, was a two-year project that began in 2019.
“With the historic district and the condition of some of those buildings, we had to change a lot of the traditional grading and underground methods of compaction,” said Setrum. “We also ran into a few other issues, including a room underneath a building porch area that we didn’t know was there until we removed the sidewalk.”
Even with the pandemic and aged downtown structures, the project moved ahead at an effective pace and was completed successfully Sept. 4.
“I will always reference this project going forward as one that could have had a lot go wrong but went so right because the parties were willing to partner and work together through unforeseen challenges,” said Setrum. “It turned out to be a very smooth, good-looking project.” The community has shown its appreciation for construction crews and MnDOT staff with thank-you emails, texts and posters. A virtual ribbon cutting celebration is set for Sept. 19.
Learn more about the project at the Hwy 12 Litchfield website.
Work on Hwy 15 in Hutchinson off to good start, on track for October completion

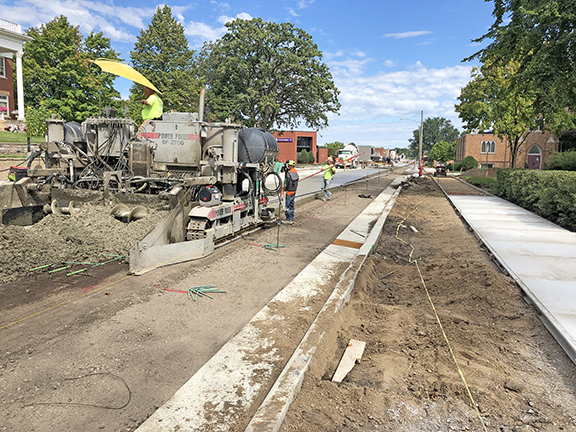

Crews pave the concrete center lane on Hwy 15 in downtown Hutchinson. Photo by Ben Sandoz |
In Hutchinson, MnDOT and the city planned for construction to take place in stages to reduce impacts to downtown businesses and residents. The project got off to a good start in April this year and is scheduled to be completed in October. In addition to the downtown reconstruction with utility upgrades, two miles of Hwy 15 is being resurfaced north of downtown, with a left-turn lane addition and pedestrian crossing upgrades.
“We’ve had a few bumps during construction, but overall, the project has gone well,” said Ben Sandoz, MnDOT construction supervisor. “It’s coming together well and on-time. With the urban projects, the challenges always seem to be the unknowns. You never know what you are going to run into until you start digging and encounter it. One example would be areas that don’t line up with what’s proposed in the plan and then having to come up with adjustments to make it work in the field.”
Good weather prevailed early in the project, which got its start during Minnesota’s stay-at-home period.
“The weather this summer is what surprised me the most,” said Sandoz. “Typically, we encounter two to four rain days every month on a project and with this project, I can count the days we lost to rain on one hand. Also, we were expecting to find contaminated soil throughout the project, but in the end, we encountered it only once. Both were pleasant surprises that are helping get this project completed on time.”
A virtual ribbon-cutting celebration is being planned for the second half of October. Learn more about the project at the Hwy 15 Hutchinson website.
The project teams emailed weekly construction updates to subscribers and posted updates on social media and the MnDOT project websites for both projects. Keeping community members informed and providing them with contact information allowed everyone to voice concerns as they arose and stay up to date on closures and construction phases. With one urban reconstruct in the books, and another just a few weeks from completion, District 8 construction staff are appreciative of the good working relationships that they experienced with the project contractors and stakeholders.
|
