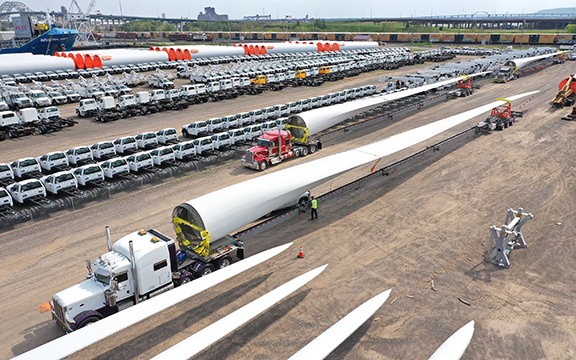

These wind tower blades, each measuring 220 feet, were transported to the U.S. via ship from India and Spain, and continued on roadways after being unloaded in Duluth. Photo by Pete Kramer, Lake Superior Warehousing
|
By Rob Holschbach, Office of Freight and Commercial Vehicle Operations
The morning began like any other Monday for motorists traveling on Minnesota highways July 22, with one exception. On this day, motorists received their first glimpse of the longest wind tower blades ever transported on Minnesota highways.
The journey for each blade began in either India or Spain. From there, the blades traveled by sea to a warehousing facility at the port of Duluth. There, 162 wind blades measuring 67 meters in length (approximately 200 feet) will be moved individually to Avon, S.D.
MnDOT’s Office of Freight and Commercial Vehicle Operations has a dedicated oversize/overweight permits unit that leads planning and coordination efforts for issuing the permits for these blades. This involves working closely with trucking companies to identify potential route plans, and coordinating with internal and external stakeholders. Then, based on the load configurations, planned route, and other aspects of these moves, the unit sets time and travel restrictions and other conditions. All of this is critical to ensure these wind blades move as safely and efficiently as possible.
“Minnesota’s infrastructure wasn’t built with these kinds of large loads in mind,” said Kristine Schadegg, heavy haul project coordinator. “Because these loads have to travel through town to get out of the port, we need to know the loads can make turns, can successfully navigate vertical clearances and narrow roads, and won’t bottom out at known humped intersections. The other big challenge is knowing about upcoming construction projects well in advance.”
Anderson Trucking Service, the Minnesota-based carrier moving these blades, is no stranger to transporting large wind components. The trucking company transports between 5,000 and 8,000 blades each year throughout Minnesota. The equipment used is a special design: a trailer with an independent back end, controlled remotely to allow the truck driver to make 90-degree turns, with a loaded vehicle configuration measuring approximately 250 feet long.
“While these are Minnesota’s largest blades to date, other parts of the country are already seeing increased blade sizes of up to 74 meters, or approximately 220 feet,” said Leah Kuechle, ATS heavy haul permits manager. “Over time, these larger blades will make their way to the Midwest on a more consistent basis.”
Moving 74-meter wind blades across Minnesota may become a reality next year. Such an endeavor requires extensive planning and coordination, and the planning process begins months before a schedule is determined.
“We coordinate with the MnDOT districts through which the loads are traveling,” Shadegg said. “We frequently work with District 1 because of the ever-increasing size of items coming into the port of Duluth. We work continuously with MnDOT district engineers and project managers, the Port Authority, the city, State Patrol, the shipper and the carrier. There are meetings to discuss travel options, like routes and times of travel, when these big projects come up. We begin working on these projects as soon as we first hear about them, sometimes a year in advance.”
To see how a move like this happens, check out this Youtube video on the largest wind turbine movement in Spain.
|
